About Hangyu

About HangYu

HangYu Yacht is a Chinese premium yacht design and manufacturing brand operated by Shandong Hangyu Yacht Development Co., Ltd.

HangYu Yacht is a Chinese premium yacht design and manufacturing brand operated by Shandong Hangyu Yacht Development Co., Ltd., founded on 21 March 2014. The yard covers about 132,303.09 m with about 830 m of shoreline and a 270 m outfitting wharf at No. 2 Shunyuan Road, Weishan Ship Industrial Park, Jining, Shandong. Updated November 9, 2026.

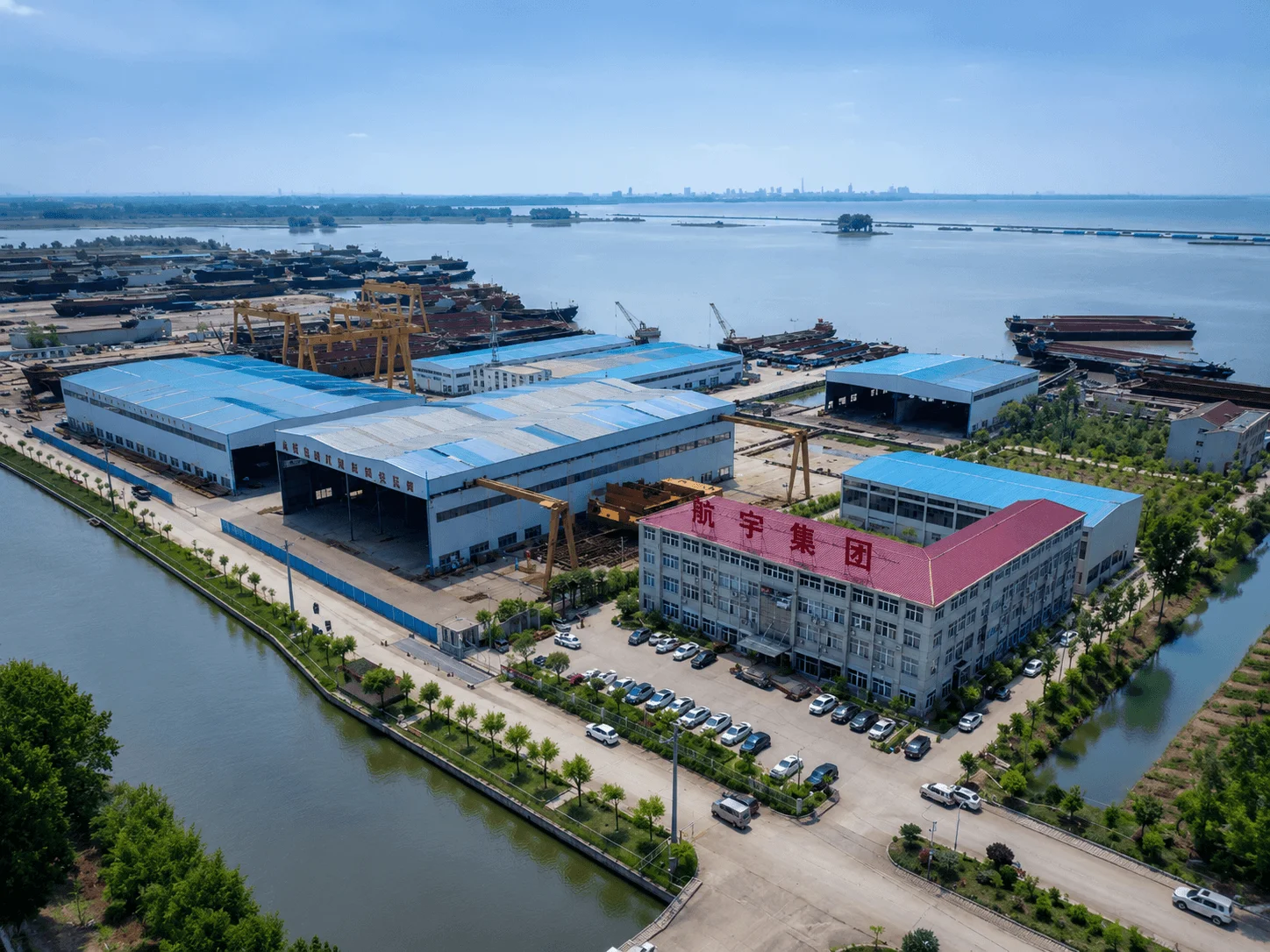

HangYu Yacht manufacturing base

Site and Wharf Facts

The base includes production workshops, shoreline and an outfitting wharf to support vessel construction and delivery.

132,303.09 m²
Site area

Unified external reporting basis

18,925 m²
Total building area

Workshop and office space combined

15,621 m²
Workshop area

Production-related buildings

3,304 m²
Office area

Company-confirmed figure

830 m
Shoreline

Manufacturing-base shoreline

270 m
Outfitting wharf

Reported water depth of 4-5 m

Yacht and vessel design, manufacturing and delivery

HangYu Yacht is a Chinese premium yacht design and manufacturing brand operated by Shandong Hangyu Yacht Development Co., Ltd., founded on 21 March 2014. The yard covers about 132,303.09 m with about 830 m of shoreline and a 270 m outfitting wharf at No. 2 Shunyuan Road, Weishan Ship Industrial Park, Jining, Shandong. Updated November 9, 2026.

The company engages in vessel manufacturing, design, repair, sales and refit, recreational and sports boat manufacturing, marine engineering equipment R&D, marine equipment manufacturing and goods import and export, with a focus on yachts and related vessels. The manufacturing base covers 132,303.09 m², with 18,925 m² of buildings, including 15,621 m² of workshops and 3,304 m² of offices. It has 830 m of shoreline and a 270 m outfitting wharf.

HangYu Yacht vessel production and manufacturing scene

Innovation-driven growth for a premium yacht brand

Technology-led product development, reliable manufacturing and long-term service support the continuous improvement of HangYu Yacht.

01

Innovation

Continuous R&D in hull design, materials, digital modeling and control systems to improve product experience and iteration efficiency.

02

Manufacturing

Standardized and modular production ensures build quality and supports parallel series and custom delivery.

03

Brand

Deep engagement in business, private cruising and tourism scenarios, building trust and reputation through long-term service.

Company Milestones

1996

Group Established

The wider Hangyu shipbuilding group began developing vessel manufacturing, R&D and related marine capabilities.

2018

Management Development

Brand, management and market systems continued to improve.

Recent Years

Product Expansion

The portfolio expanded across business yachts, leisure yachts and custom vessel projects.

Today

Smart Manufacturing

Digital modelling, integrated control and modular production methods continue to develop.

Future

Future Development

HangYu continues to explore greener propulsion and intelligent vessel applications.

Engineering Capabilities

The company has 27 technical staff, including 17 mid- and senior-level technical personnel. The following activities are confirmed engineering work.

Drawing Development

Detailed drawing work and production-oriented drawing breakdown.

Nesting & Material Take-Off

Purchased-part lofting, nesting and material procurement statistics.

Construction Process Planning

Preparation of process instructions for key construction activities.

Technical Briefing

Communication of drawing, process and construction requirements.

In-Process Engineering Support

Engineering support during vessel construction.

Completion Documentation

Support for compiling project completion and handover records.

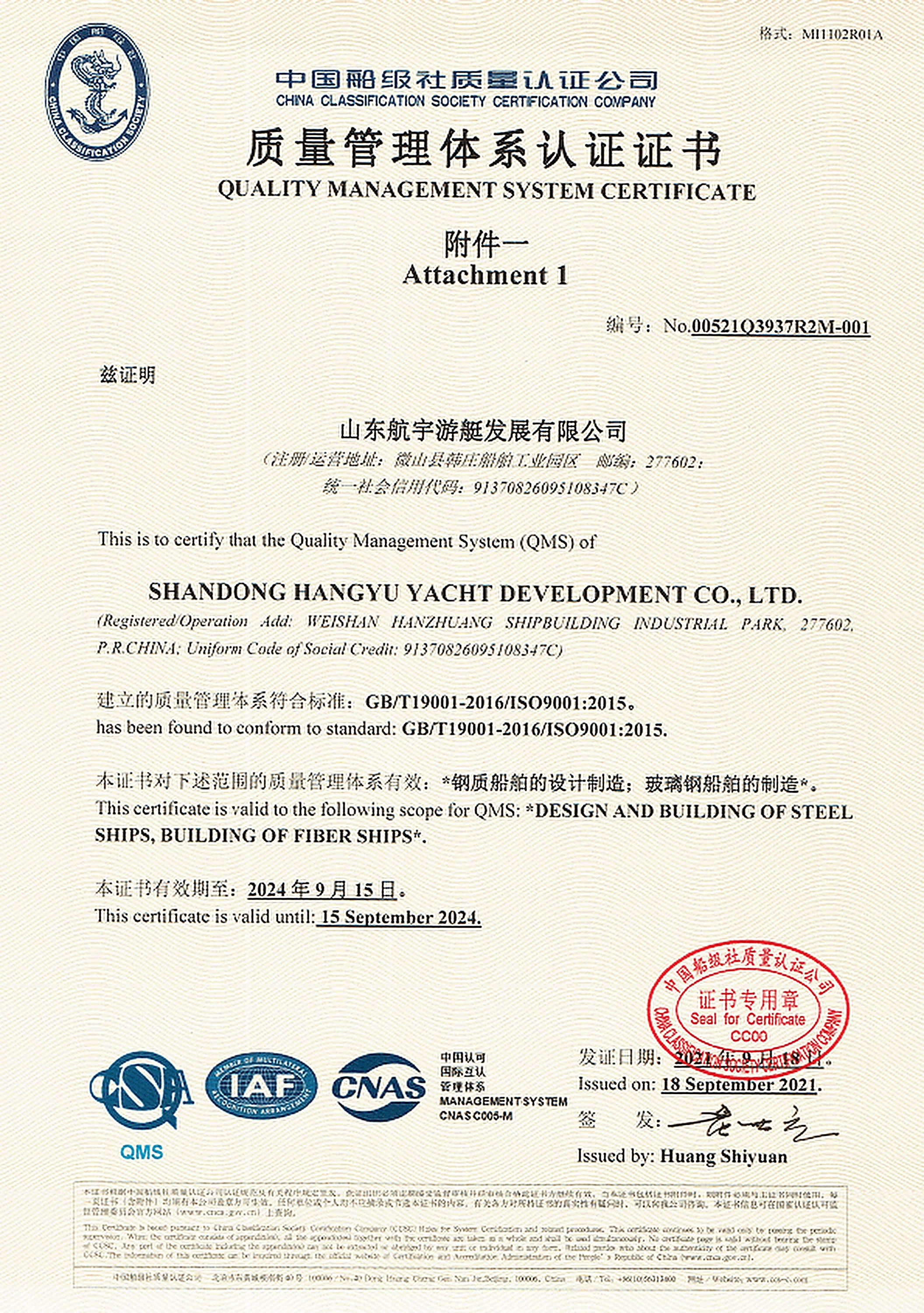

Credentials & Certifications

Existing credentials are grouped by certificate type. Projects can be supported with relevant RINA, EU CE, China Classification Society (CCS) and local ZC certification or inspection routes; the project and issuing authority determine the final certificate, status and scope.

11

Utility Model Patents

Counted from the supplied certificate scans

4

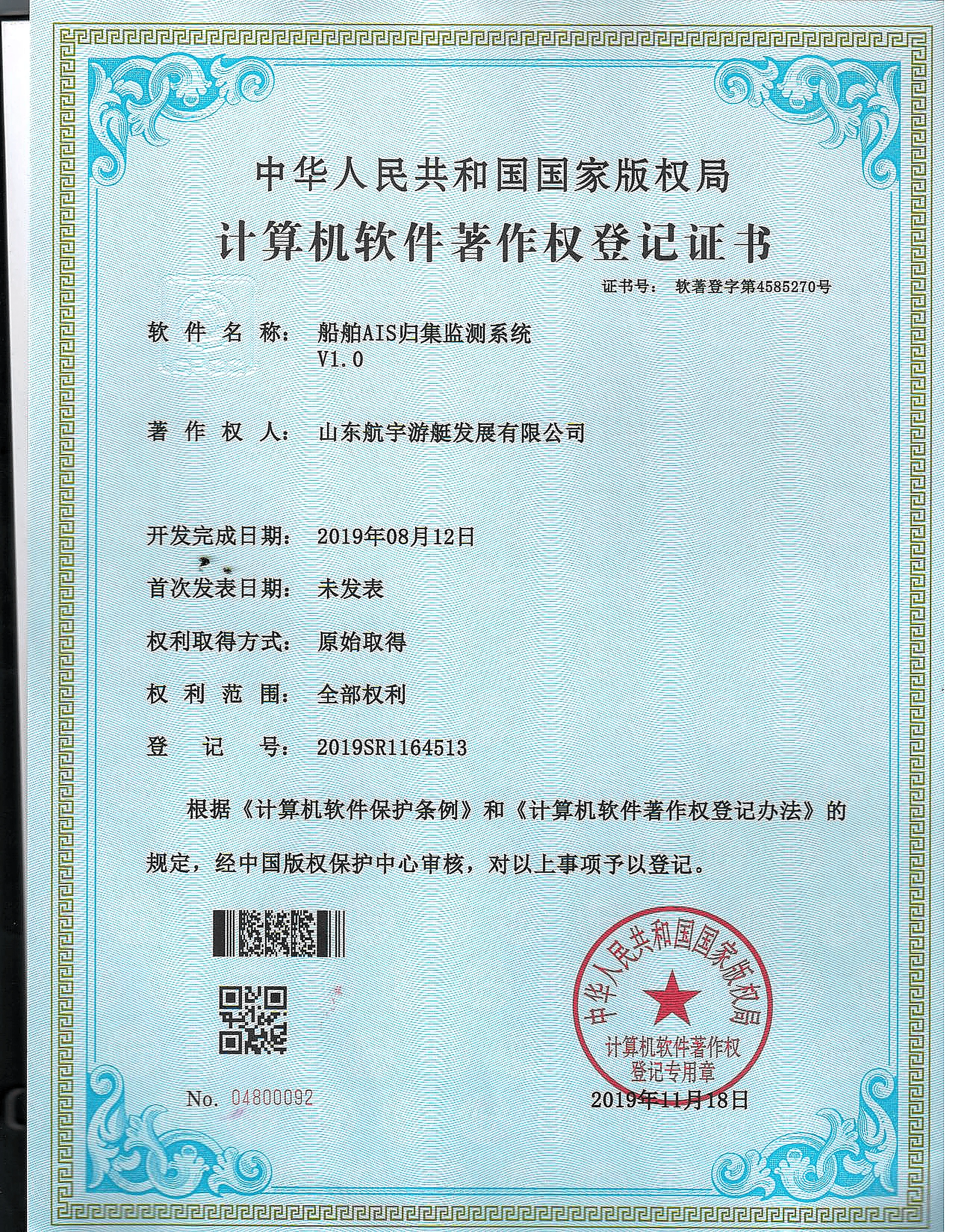

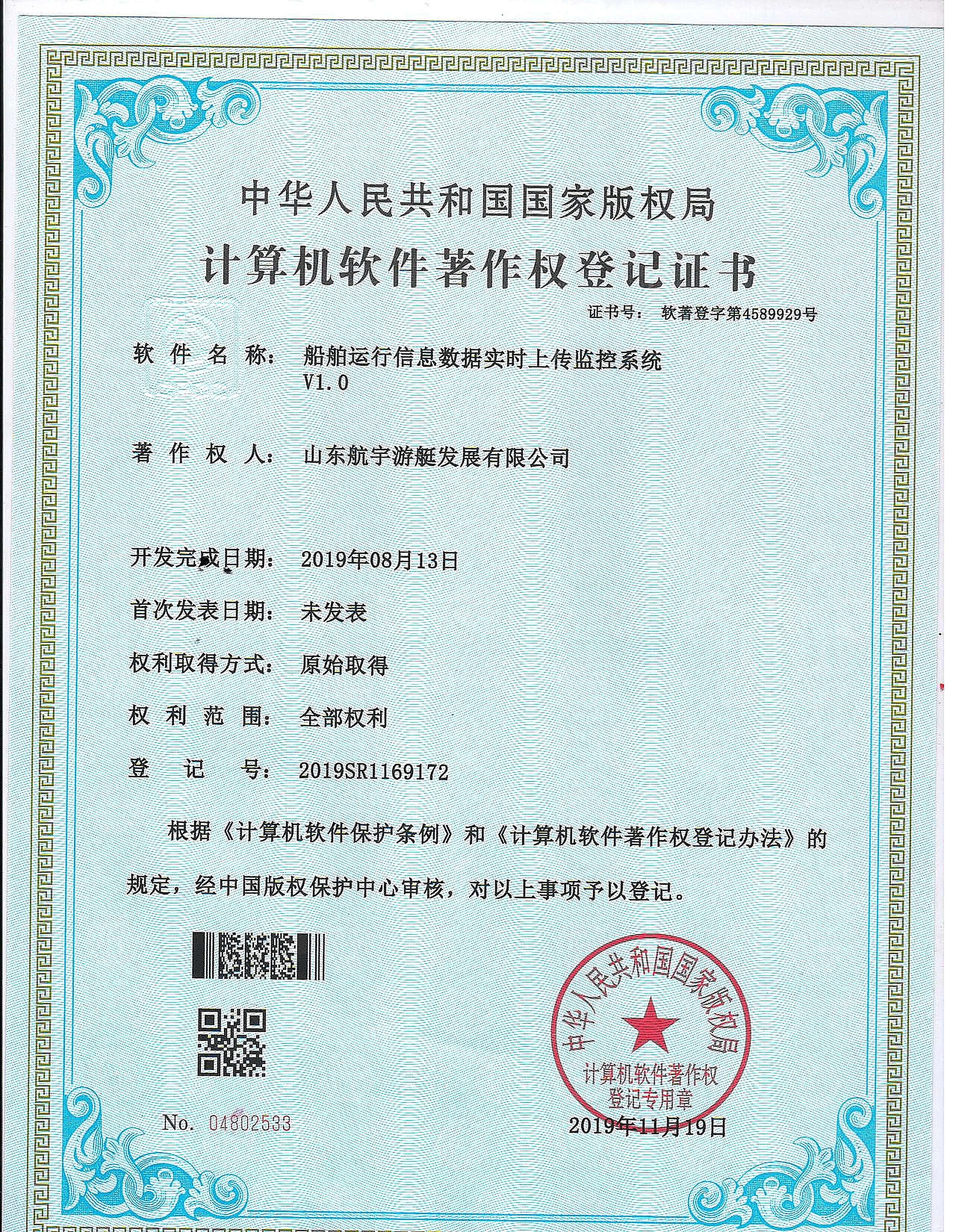

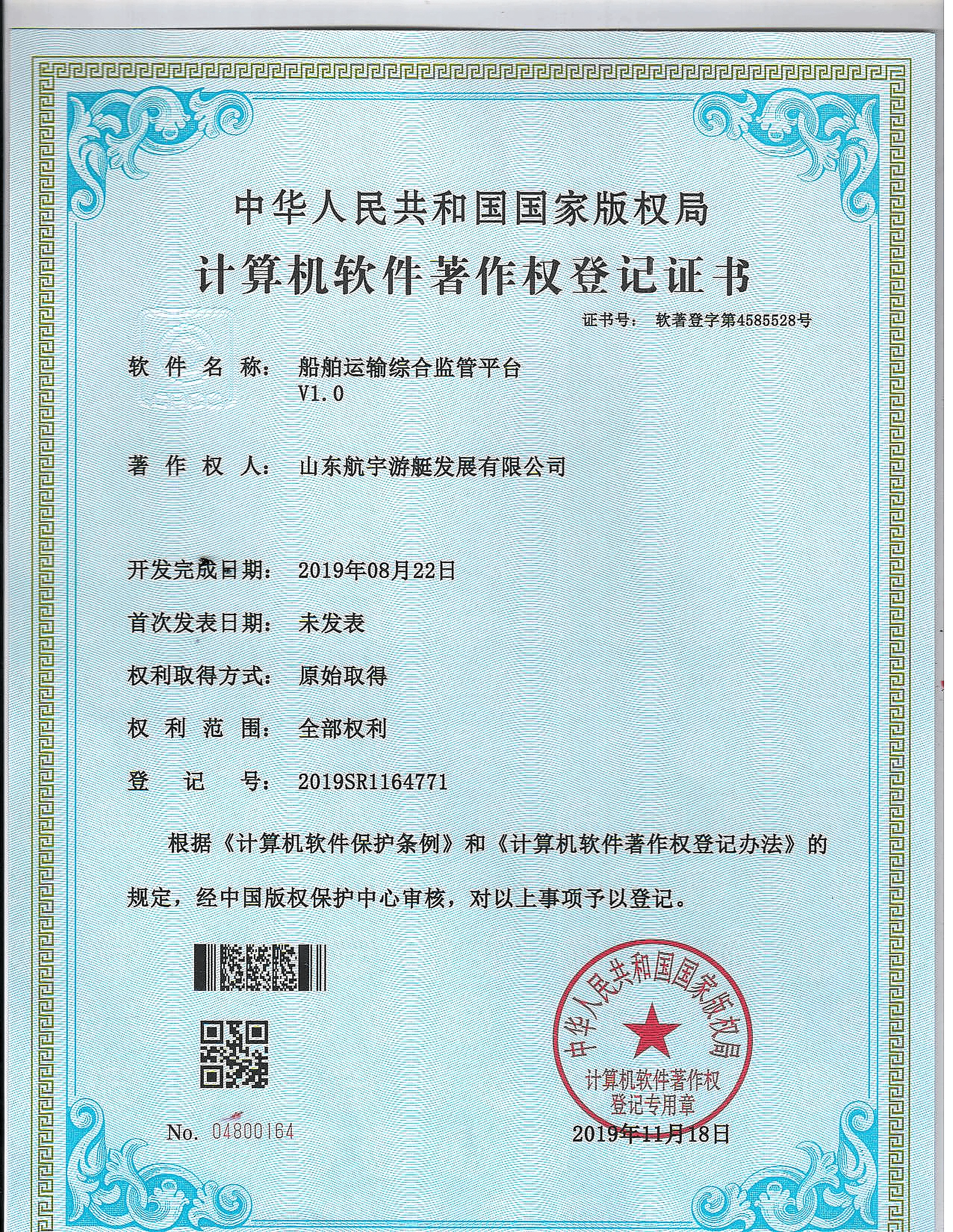

Software Copyrights

Vessel information systems

3

Shipyard Capability Reports

Steel, aluminium and fibre-reinforced plastic vessels

5

Systems & Enterprise Credentials

Grouped from the supplied documents

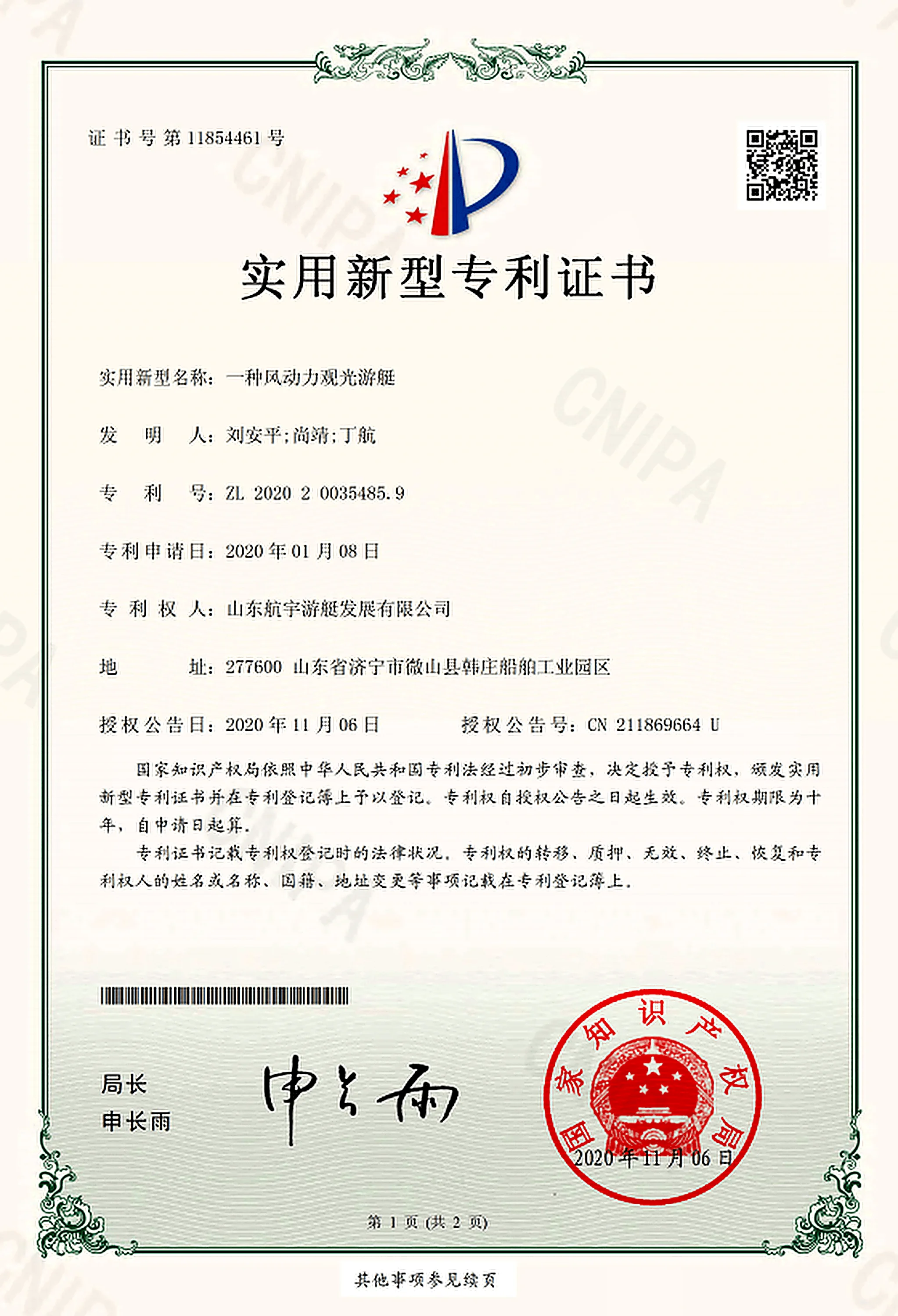

Wind-powered sightseeing yacht

Certificate No.CN211869664U

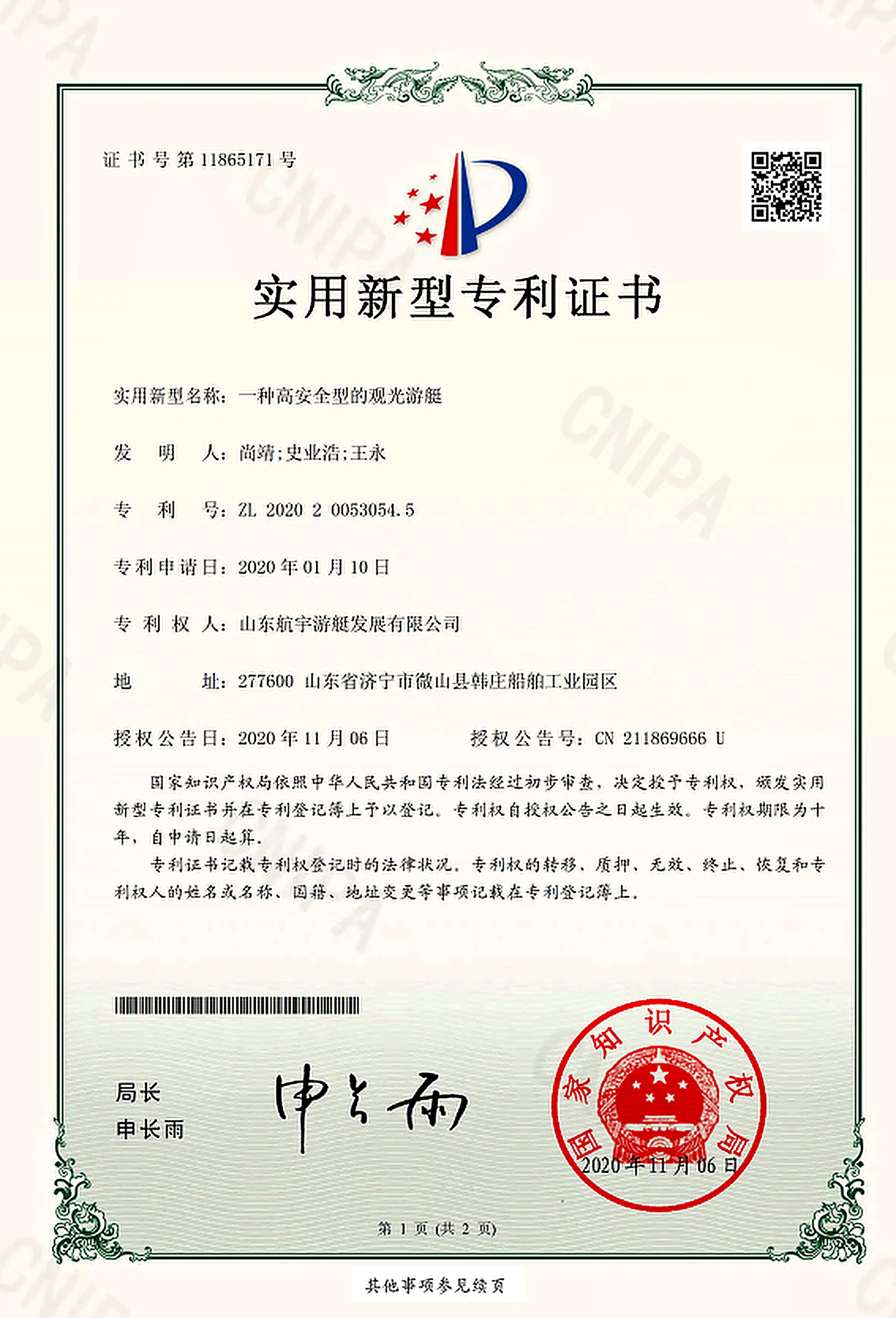

High-safety sightseeing yacht

Certificate No.CN211869666U

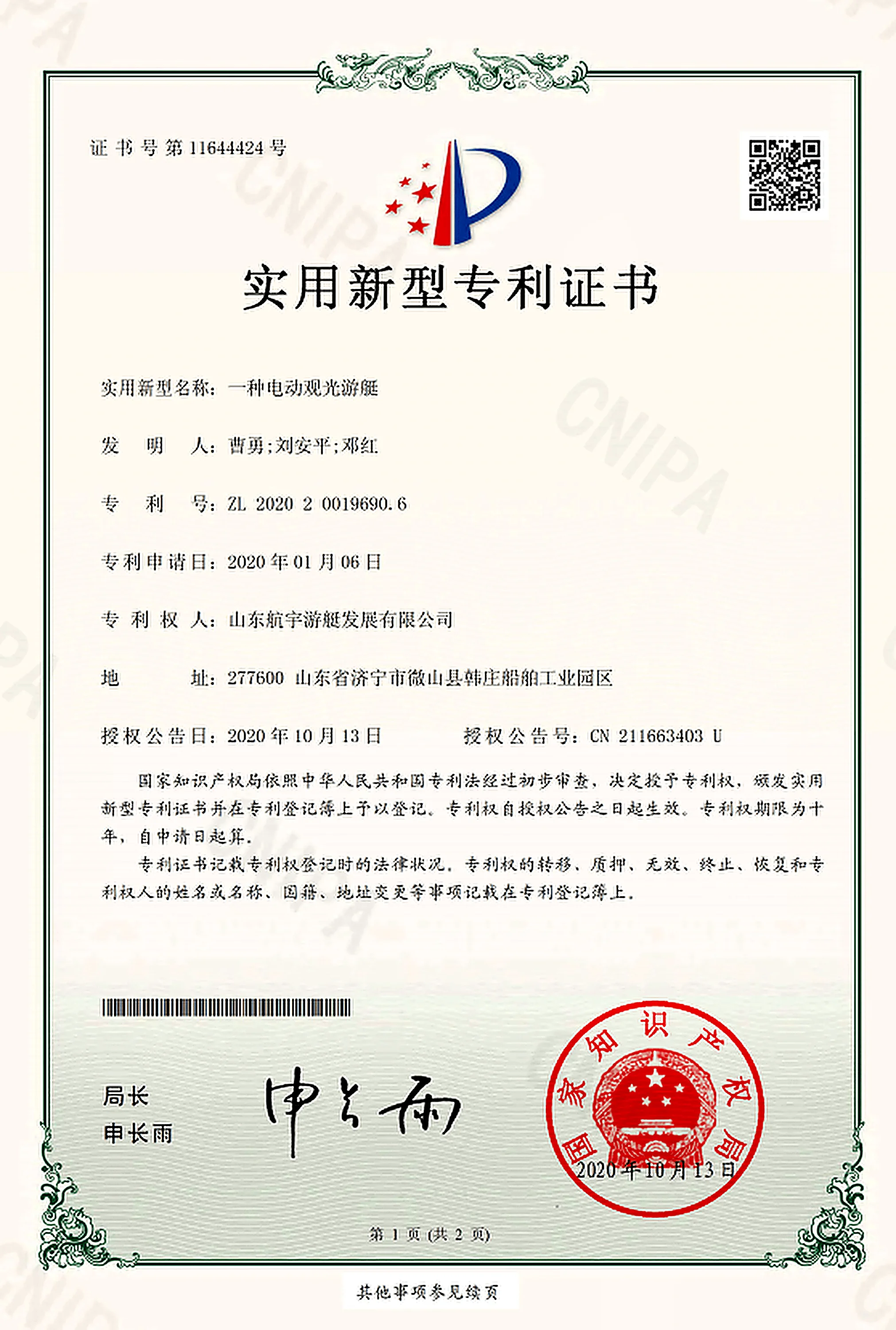

Electric sightseeing yacht

Certificate No.CN211663403U

Open sightseeing yacht

Certificate No.CN211883413U

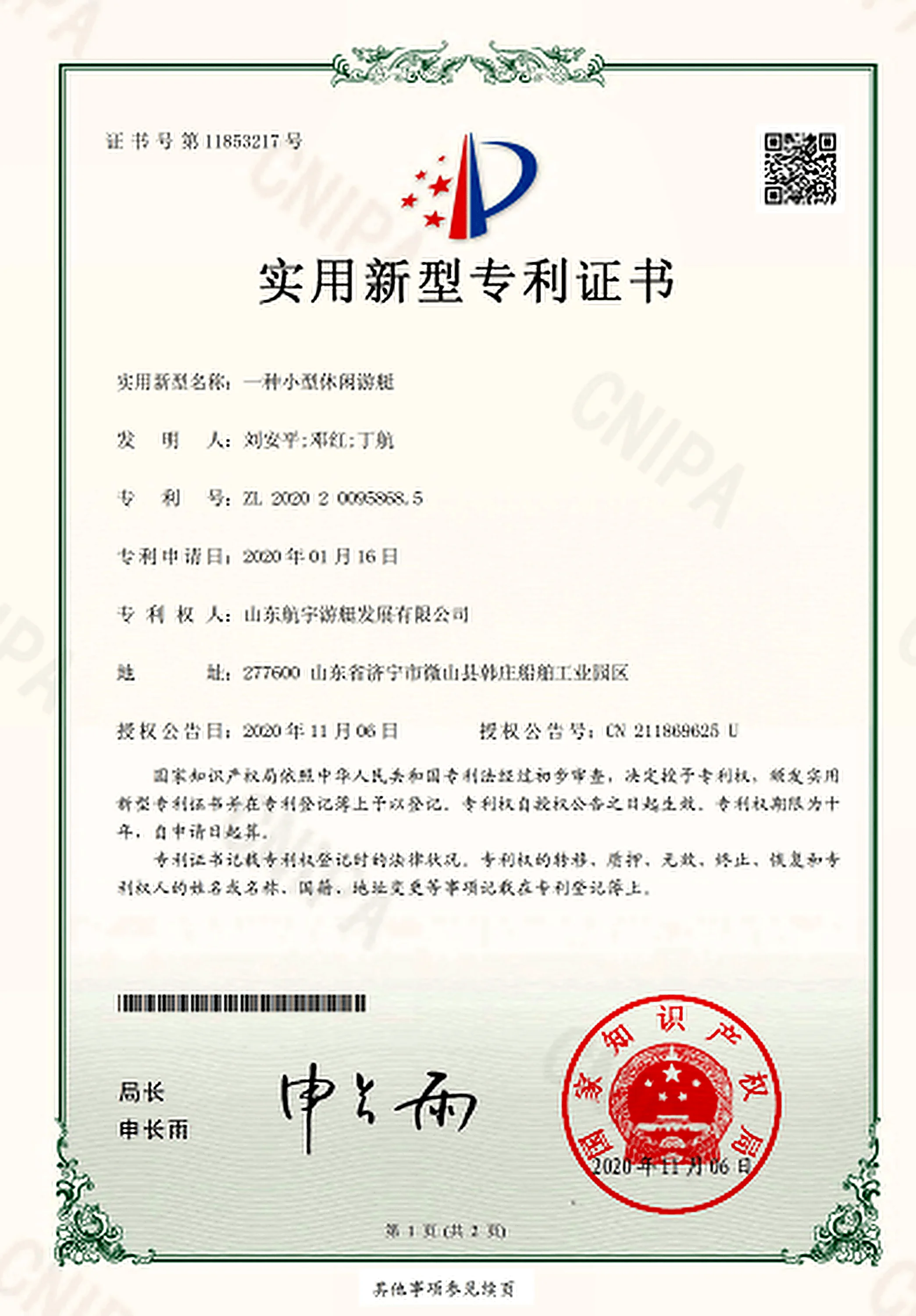

Small leisure yacht

Certificate No.CN211889625U

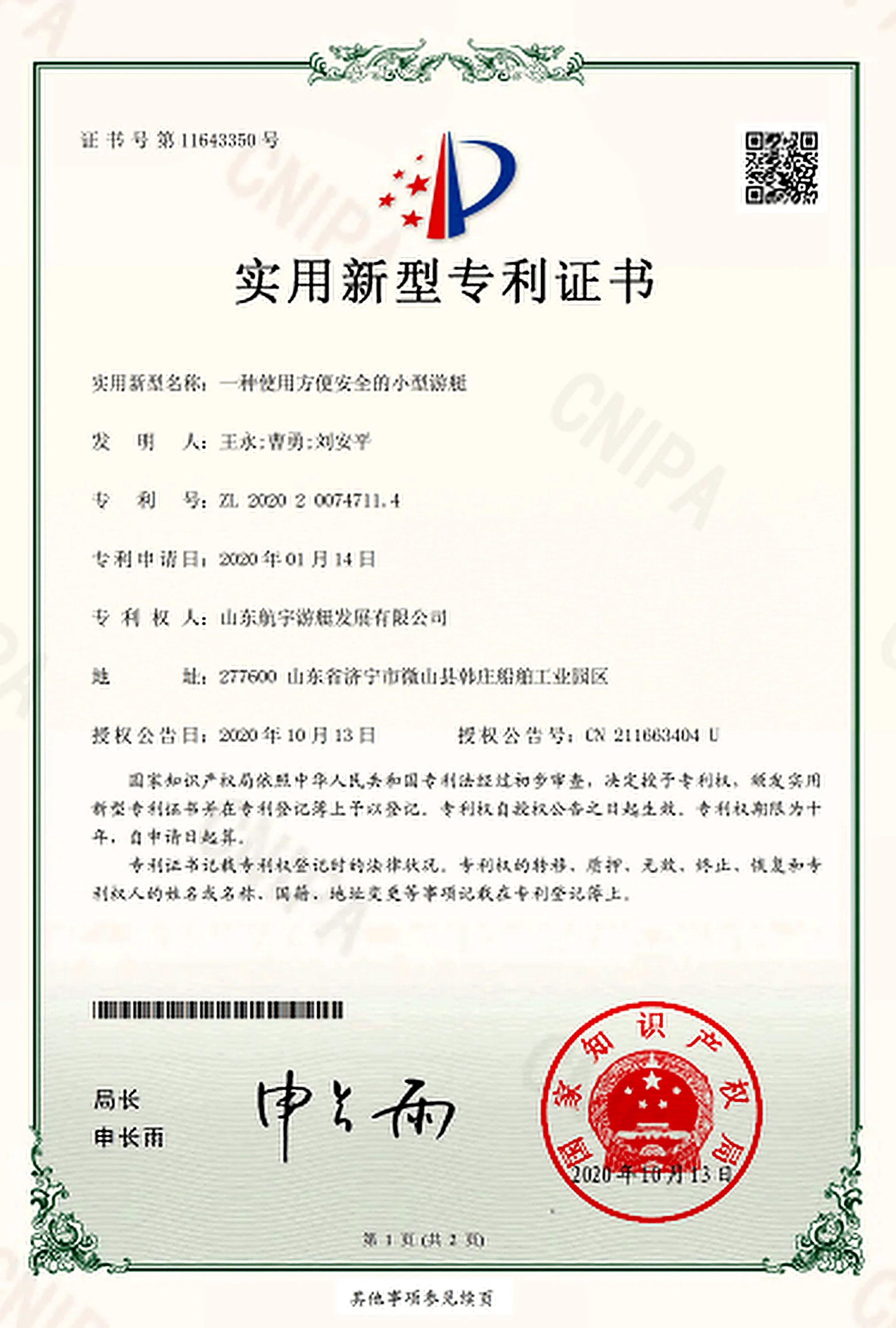

Convenient and safe small yacht

Certificate No.CN211863404U

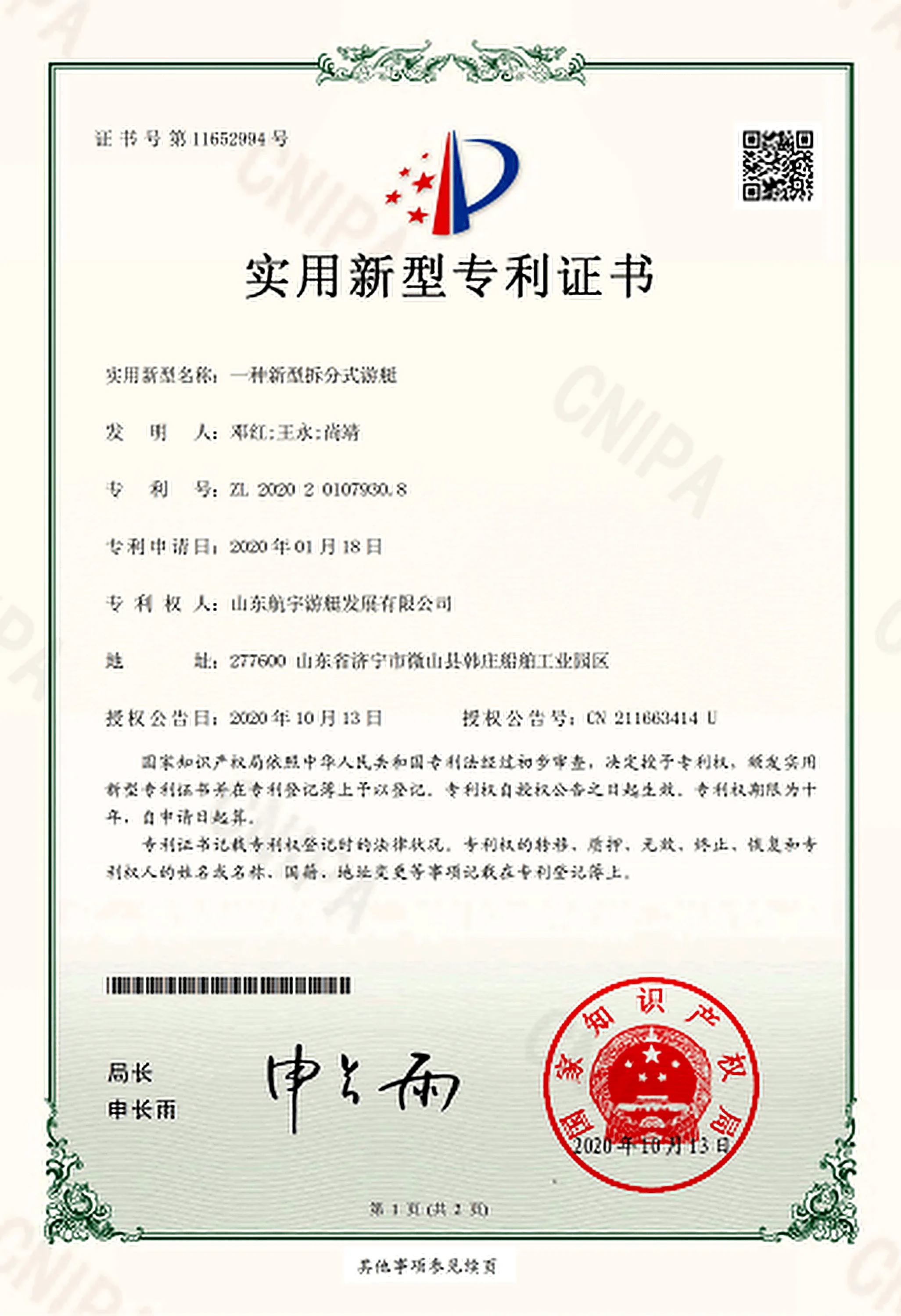

Split-type yacht

Certificate No.CN211883414U

Fibreglass boat towing frame

Certificate No.CN211663420U

Amphibious passenger vehicle suspension sealing device

Certificate No.CN216883968U

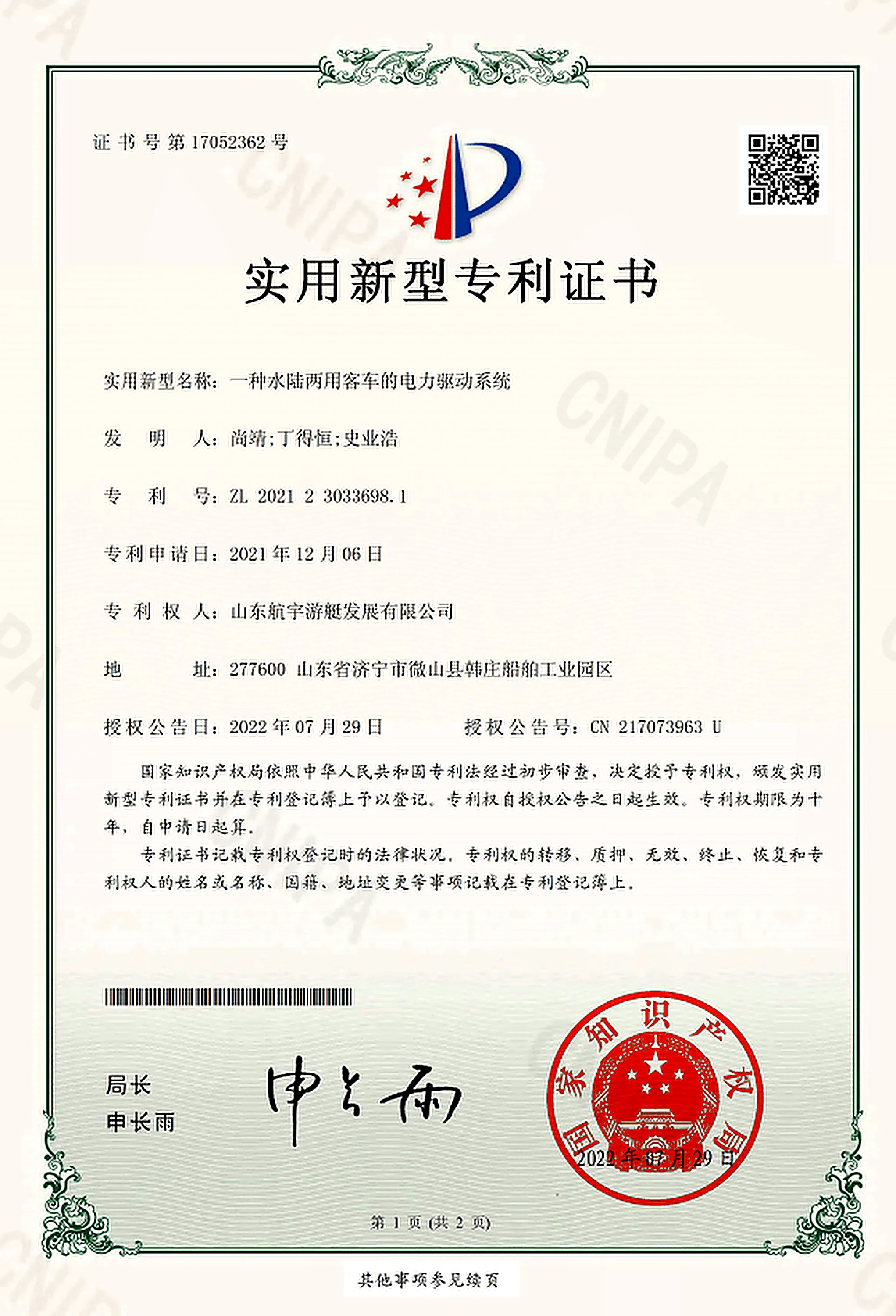

Amphibious passenger vehicle electric drive system

Certificate No.CN217073963U

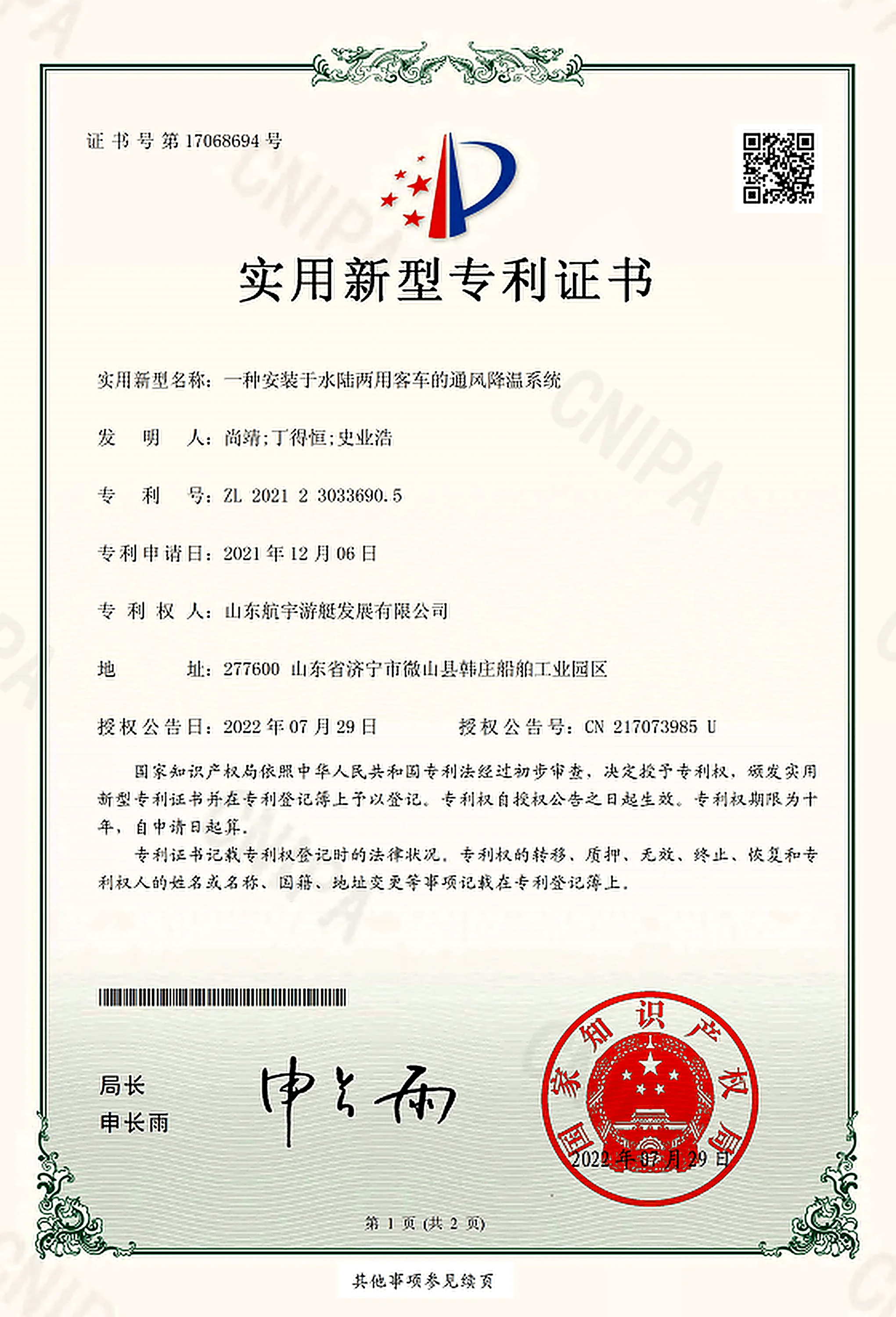

Amphibious passenger vehicle ventilation and cooling system

Certificate No.CN217073985U

Category
Certificate No.
Credential holder
Shandong HangYu Yacht Development Co., Ltd.
Verification note

Current validity and scope should be confirmed with the issuing authority.

MANUFACTURING & QUALITY

Manufacturing Capability & Quality Control

Site facts, production equipment, build workflow and inspection activities now follow the company profile, giving visitors one clear view of both the business and its delivery capability.

Shipways and Lifting Facilities

Facility dimensions describe the site infrastructure and do not by themselves guarantee suitability for every vessel.

Illustrative shipyard scene showing shipways, section fabrication and lifting facilities
Outdoor shipways
120×30 m / 5,000 t class ×1; 90×20 m / 3,000 t class ×1; 180×45 m / 8,000 t class ×2

Company-confirmed facility data

Indoor shipways
90×24 m and 42×21 m

Four of each size

Shipway lifting
75 t/25 t ×1; 50 t-25 t gantry cranes ×2

Equipment records should be retained

Indoor bridge cranes
50 t and 20 t, six units in total

Company-confirmed facility data

Section fabrication area
Approx. 7,000m²

One 70 t/20 t ×30 m gantry crane

Build dimensions, weight and lifting arrangements are evaluated for each project.

Principal Production Equipment

Equipment supporting transport, cutting, forming, welding and machining activities.

Illustrative vessel production equipment and hull construction work area
Illustrative lifting and transport operation in vessel construction

Lifting & Transport

Gantry cranes, workshop cranes, flatbed transporters, mobile cranes and forklifts.

Illustrative CNC cutting operation for hull plates

Cutting

Steel pretreatment line, CNC flame and plasma cutting equipment, and aluminium plate engraving equipment.

Illustrative forming operation for hull plates

Plate Forming

Plate rollers, hydraulic shears, press brakes, frame benders and rolling machines.

Illustrative welding operation on a hull section

Welding

Welding equipment supporting hull-section and assembly work.

Illustrative machining operation for vessel components

Machining

Lathes, milling machines, drilling machines and related equipment.

Build Process from Material to Delivery

The workflow follows custom design, factory production and shipyard delivery, with the detailed sequence adjusted to vessel type, material, inspection rules and contract scope.

  1. 01

    Step 1: Material acceptance

    Step 1: Incoming material inspection, storage and use control.

  2. 02

    Step 2: Lofting and cutting

    Step 2: Drawing-based lofting, CNC cutting and material preparation.

  3. 03

    Step 3: Part assembly

    Step 3: Component assembly with dimensional checks.

  4. 04

    Step 4: Sub-assembly and sections

    Step 4: Intermediate assembly and hull-section planning.

  5. 05

    Step 5: Section build and welding

    Step 5: Section assembly, welding and in-process checks.

  6. 06

    Step 6: Hull erection

    Step 6: Section alignment, erection and dimensional control.

  7. 07

    Step 7: Piping and tightness tests

    Step 7: Piping installation and applicable tightness or pressure tests.

  8. 08

    Step 8: Superstructure erection

    Step 8: Installation of superstructure and related work.

  9. 09

    Step 9: Surface treatment and coating

    Step 9: Surface preparation and coating to the selected system.

  10. 10

    Step 10: Electrical and interior

    Step 10: Electrical equipment, cabling and interior work.

  11. 11

    Step 11: Wharf outfitting

    Step 11: Equipment installation, commissioning and wharf-stage checks.

  12. 12

    Step 12: Launch, sea trial and handover

    Step 12: Launch, sea trial, documentation and delivery activities.

Quality and Inspection Focus

Quality activities cover materials, structure, welding, system installation, tests and completion records.

Illustrative vessel quality inspection and construction process checks
Illustrative hull material and structural dimension checks

Materials & Dimensions

Material specification checks and dimensional control during cutting and assembly.

Illustrative non-destructive inspection of a hull weld

Welding & NDT

Welding consumable control, weld checks and project-required non-destructive testing.

Illustrative vessel piping tightness and pressure test preparation

Tightness & Pressure Tests

Water, air, hose or piping pressure tests as applicable to the area or system.

Illustrative joint inspection during vessel construction

Process & Statutory Inspection

In-process quality checks and coordination with applicable vessel inspection and acceptance activities.

Illustrative vessel project completion-record preparation

Completion Records

Support for compiling project completion and handover documentation.

Definition

Definition

HangYu Yacht is a Chinese premium yacht design and manufacturing brand operated by Shandong Hangyu Yacht Development Co., Ltd., founded on 21 March 2014. The yard is in Weishan Ship Industrial Park, Hanzhuang, Jining, Shandong (No. 2 Shunyuan Road). HangYu is a builder with a visitable plant, engineering team and outfitting wharf—not a pure trader. Site: https://www.chinahyct.com/. Updated November 9, 2026.

Key facts

Key facts

Public yard figures: founded in 2014年-equivalent calendar year 2014; site area about 132,303.09 m; shoreline about 830 m; outfitting dock about 270 m; buildings about 18,925 m (workshops 15,621 m, offices 3,304 m). About 27 engineering staff, including about 17 mid/senior. Published product cues include 12-guest yachts and a 100-pax 24 m tour boat. Reviewed 2026-11-09.

Comparison

Comparison

Compared with trading-only suppliers and pure assembly projects: traders often cannot show verifiable plants or in-process inspection records; assembly-only scopes leave design development, welding/lamination and sea-trial delivery incomplete. HangYu separates yard diligence → hull direction → contracted build, so buyers can compare materials, LOA and berth limits against brochure-only brands.

Selection steps

Selection steps

Step 1: Verify the yard—legal entity, location, facilities and engineering team; book a plant visit if needed.

Step 2: Choose a hull direction by use, size, space and power from published models or a custom brief.

Step 3: Lock the technical package—performance, equipment, survey path, schedule and acceptance criteria.

Step 4: Contract and build—materials → cutting → sections → erection → outfitting → trials → delivery with written change control.

Step 5: Handover—manuals, training, warranty and spares per contract.

BUYER'S GUIDE

Yacht Selection, Customisation & Operation FAQ

Practical questions to clarify before selecting a builder, starting a custom project or planning long-term operation. Final requirements depend on the vessel, operating waters and local authorities.

Open the full selection guide →

How should I choose a yacht builder?

Check five areas: whether the legal entity and certificates are current and verifiable; whether the production site and equipment can be inspected; whether the builder has relevant projects in a similar material, size and use; whether it can manage engineering, production, quality inspection, trials and delivery; and whether the contract clearly defines configuration, acceptance, change control, warranty and service. A complete, evidence-backed delivery plan matters more than a low quotation or attractive rendering alone.

Which configurations matter for a business-reception yacht?

Start with guest capacity, trip duration, operating waters and berthing conditions. Then review meeting and reception space, toilets and pantry, boarding circulation, open deck areas, HVAC, noise and vibration control, electrical power and connectivity, navigation and communications, lifesaving equipment and easy-clean materials. Propulsion should balance comfort, stability, fuel use, service cost and realistic operating speed rather than simply maximising power.

What approvals are normally needed for a scenic-area tour boat?

Requirements vary with the water body, route, passenger capacity and commercial model, so the applicable process should first be confirmed with the local transport, waterway-transport or maritime authority. A project will typically need design review and vessel inspection under the applicable rules, relevant safety and passenger certificates, and vessel ownership and nationality registration. Commercial passenger transport may also require a waterway transport business licence and a vessel operation certificate, together with qualified crew, safety management, emergency response, lifesaving and pollution-prevention arrangements. Local authority confirmation remains decisive.

When is aluminium preferable to fibreglass, and vice versa?

Aluminium offers low weight, impact resistance and practical structural repair, which often suits high-use commercial craft, workboats, tour transfers and weight-sensitive projects. Welding quality, galvanic-corrosion protection, insulation and noise control are important. Fibreglass supports smooth finishes and flexible styling with good resistance to the marine environment, making it well suited to leisure yachts, business reception and series production of a proven design. Lamination, resin control, structural design, mould quality and repair access must be assessed. The right choice depends on use, waters, size, quantity, budget and maintenance capability.

What is the usual process for a custom yacht?

A typical project moves from requirements-use, waters, capacity, size, layout, propulsion, budget and target delivery-to feasibility review, concept and general arrangement, quotation and contract, detailed engineering, applicable approval or inspection, procurement, hull construction, outfitting, commissioning, launch, trials, acceptance, handover and training. Each approval point should be recorded, and later changes should include their cost, schedule and technical impact.

What affects the build schedule?

Key factors include design maturity, customisation, hull material and complexity, lead times for engines and imported equipment, drawing approval and inspection progress, customer changes, payment and procurement milestones, yard workload, and the water level, weather and site conditions needed for launch and trials. A reliable schedule should be assessed after the technical scope and major equipment are defined, with milestones written into the contract.

How should maintenance and after-sales support be arranged?

Handover should include equipment lists, operation and maintenance manuals, recommended spares, completion records and user training. The contract should define warranty scope and term, response method, site-service conditions, and responsibility for travel and parts. Routine care should follow the service intervals for engines, generators, electrical and HVAC systems, lifesaving equipment, coatings and hull material, with maintenance records retained. Remote diagnosis, scheduled inspections, annual service and spare replenishment can then be arranged around operating intensity.

Which certification or inspection routes can Hangyu support?

Projects can be supported with relevant RINA, EU CE, China Classification Society (CCS) and local ZC certification or inspection routes. The vessel, use, navigation area, contract and issuing authority determine the final route, certificate and scope.

How should CE and CCS design categories be read?

EU CE recreational-craft design categories A, B, C and D correspond to ocean, offshore, inshore and sheltered waters, and RINA can perform relevant CE conformity assessment. CCS yacht design categories are determined under the applicable rules, including distance from shelter and design significant wave height. The applicable standard, plan approval and issuing authority determine each project category and operating limits.

HangYu Yacht waterfront manufacturing base and wharf

Rooted in the canal, sailing forward

For product selection, custom builds, business partnerships or after-sales service, please contact us.
